4 October 2021

We're starting to build the missing link in Melbourne's freeway network.

North East Link will finally fix the missing link in Melbourne’s freeway network. It will reduce travel times between the M80 Ring Road and the Eastern Freeway by up to 35 minutes, take 15,000 trucks off local roads a day, and give local roads back to local communities.

The project will deliver a massive upgrade to the Eastern Freeway, Melbourne’s first dedicated busway and more than 25km of new and upgraded walking and cycling paths.

This year builders will be moving around 100 above and underground services out of the way of North East Link. Power, water, gas, sewer and telecommunication services need to be moved to make way for major construction from 2021.

Key early works:

M80 Ring Road interchange

  • Telecommunication towers will be moved

Watsonia Station

  • 2 high voltage transmission towers will be moved

Yallambie

  • A new power substation will be built next to Greensborough Road

Borlase Reserve

  • Essential services and a water pressure reducing station will be moved

Yallambie and Bulleen

  • Sewers will be moved

Greensborough Road

  • New gas, power and telecommunications lines will replace current services along Greensborough Road

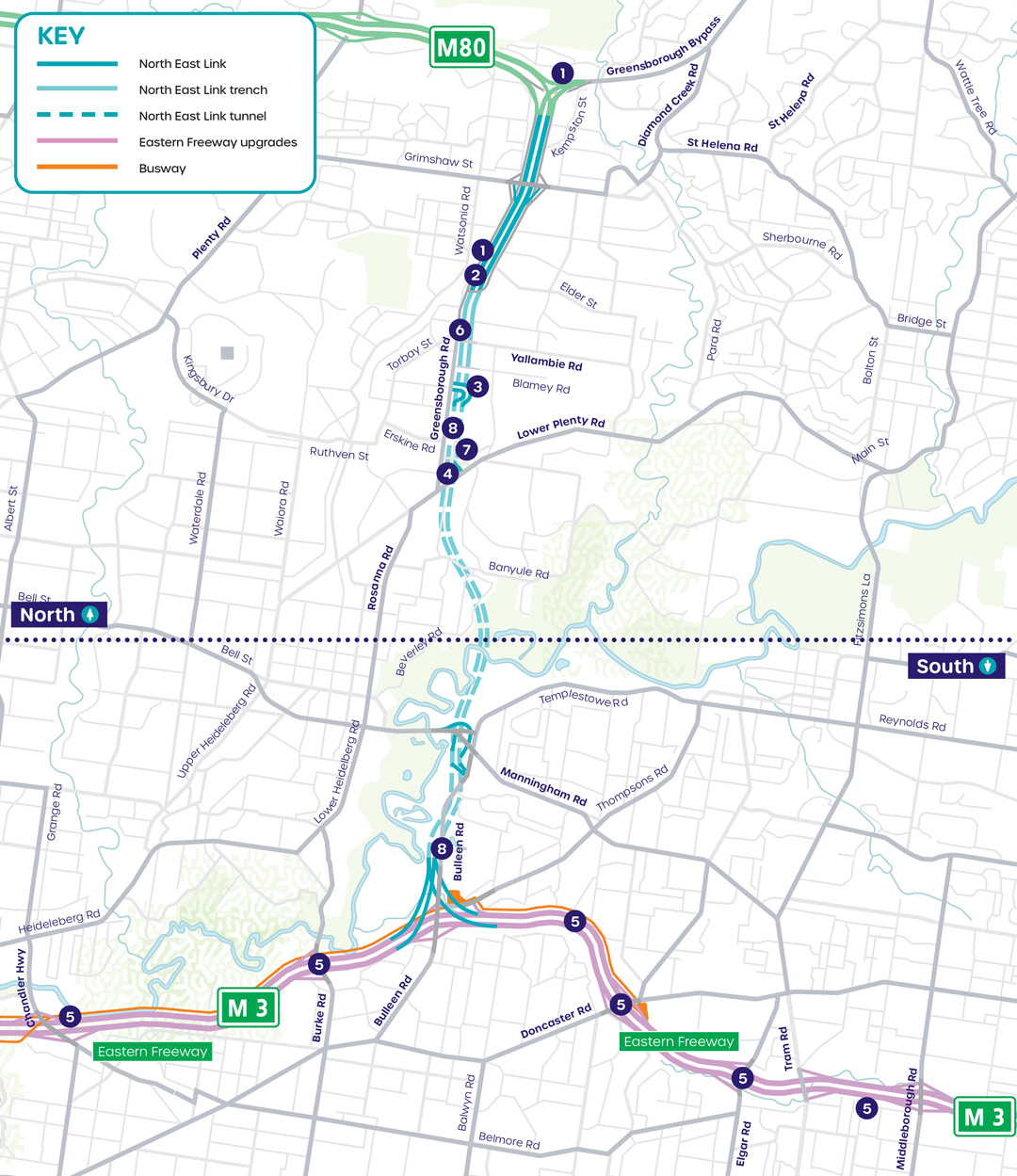

Key early works activities

1. Telecommunication towers

Late 2020 - early 2021

2 mobile telecommunications towers near the M80 Ring Road and the Watsonia Station carpark will be moved a short distance from their current location.

2. High-voltage transmission towers

Early 2021 to mid 2021

2 high-voltage transmission towers in Watsonia Station carpark will be moved to the easement on the other side of Greensborough Road.

3. New power substation

Early 2021 to early 2022

A new power substation will be built near Blamey Road to supply power to the tunnel boring machines during construction and when North East Link opens.

4. Borlase Reserve utilities

Mid 2020 to late 2020

Above and below ground power, water, gas, sewer and telecommunications lines will be moved. A temporary site compound will be built to manage the works and provide a safe environment for workers.

5. Eastern Freeway service relocations

Mid 2020 to mid 2021

To allow for upgrades to the Eastern Freeway, above and below ground power lines, communication assets and water mains will be moved.

6. Greensborough Road

Mid 2020 to early 2021

New gas, power and telecommunications lines will replace existing services along the length of Greensborough Road. To keep traffic moving and complete works safely, we'll be making some temporary changes to the alignment of the road.

7. Water pressure reducing station

Mid 2020 to late 2020

The water pressure reducing station (PRS) on the corner of Borlase and Drysdale Streets (shown in the image) will be moved to ensure the continued safe supply of water to homes and businesses.

8. Sewer realignments

Mid 2020

Underground sewer lines up to 2 metres wide in Yallambie and Bulleen will be moved.

Questions and answers

What are early works?

Early works will clear the way for major works to start in 2021. This year we'll be:

  • moving power, water, gas, sewer and telecommunications lines
  • building new services such as power to help build and operate North East Link.

Who is delivering the early works program?

CPB Contractors have been appointed to deliver the early works.

Why are early works needed?

To get ready to build North East Link and make sure we can start quickly and minimise disruptions, we need to move services and utilities out of the way.

How will you manage impacts on the community?

Before works start, we'll speak with residents and businesses about what works are planned in their area, what to expect and how any disruptions will be managed.

Strict requirements will be in place to manage construction impacts, including noise, dust and vibration.

For more information about the North East Link Program's Environmental Performance Requirements (EPRs), visit our website.

When will early works start and finish?

Work will start in the first half of 2020 and is expected to be completed in 2021 ready for major construction to start.

How many utilities will you relocate?

Approximately 100 utility services will be moved. These include key assets such as:

  • power, water, gas, sewer and telecommunications lines
  • mobile telecommunications towers
  • high-voltage transmission towers
  • a water pressure reducing station in Yallambie.

Will my travel be affected by early works?

While disruptions to get this massive project built are unavoidable, we know that through careful planning and consultation with communities we can manage this well.

There will be some disruptions for roads and streets in and around the project area. We are committed to providing you with enough notice so that you can plan your journey and allow for extra travel time if needed.

Up to date information on travel disruptions can be found on our website.

How do I speak to someone about the works?

You can contact a member of the project team, 24 hours a day, 7 days a week by calling 1800 105 105.

What happens after early works?

While early works are happening, teams of some of the world’s best and biggest builders are preparing bids to design the entire project and build the North East Link tunnels. The preferred team, design and construction timelines will be known later this year. Early works are expected to be finished by early 2021, ready for major works to start soon after.

How do I stay up to date?

To receive regular updates on the North East Link Program register your details using the online form. You can also follow us on social media.

North East Link fast facts

  • Up to 35 minute faster trips between the Ring Road and the Eastern Freeway
  • 15,000 trucks off local roads a day
  • More than 10,000 new jobs
