25 June 2025 to 1 August 2025

Glen Waverley施工最新消息

Works are underway in Glen Waverley to deliver Suburban Rail Loop (SRL) East for Melbourne and Victoria.

What we are doing

Day works 7am to 6pm Monday to Friday and 7am to 1pm Saturday
Night works 6pm to 7am Monday to Sunday
Extended works 1pm to 5pm Saturday and 7am to 1pm Sunday
24 hour works 7am Monday to 7am Sunday

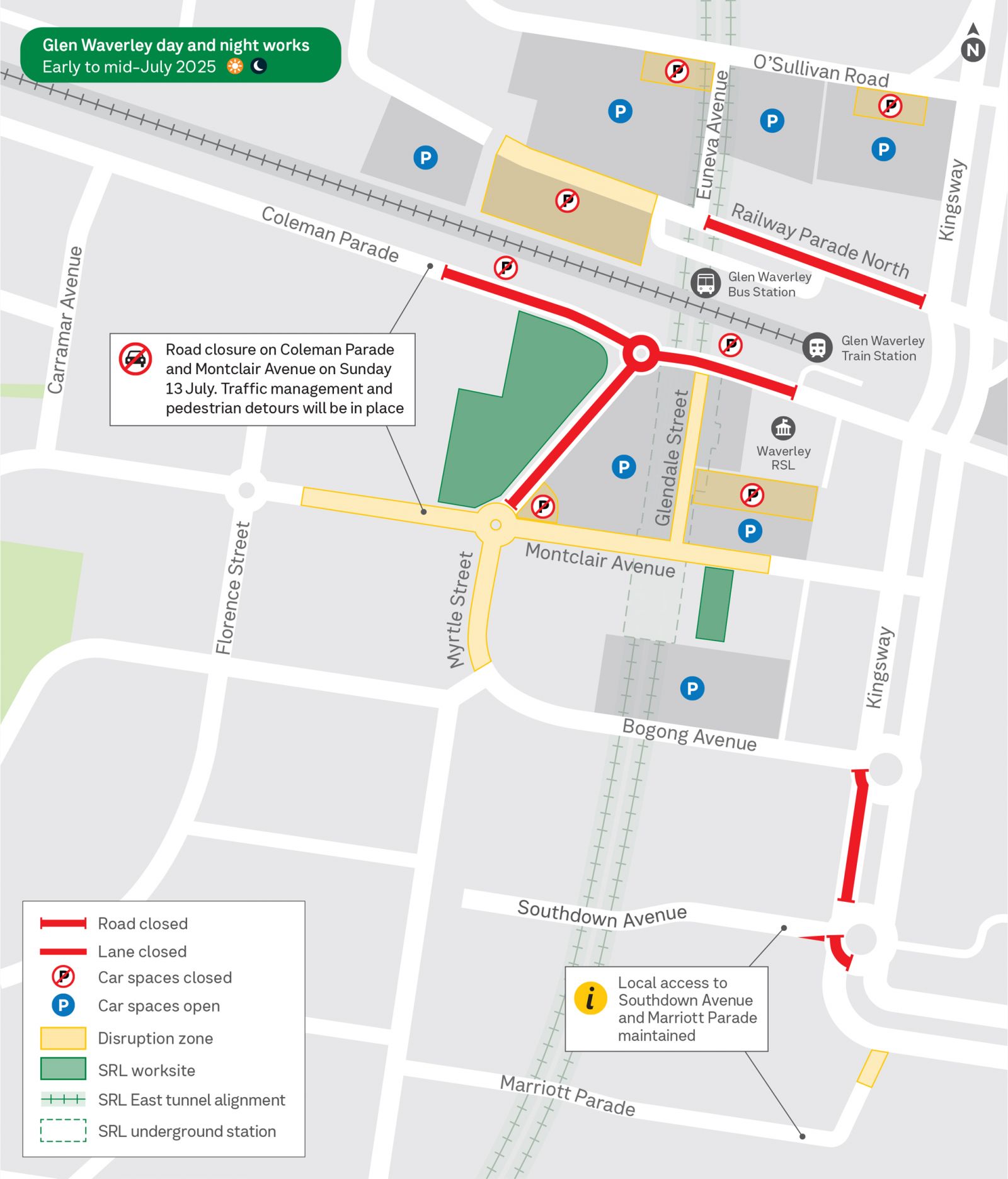

Glen Waverley day and night works. Early to mid July 2025.

WhereWhen What we are doing What to expect
Myrtle Street, Glen Waverley Day/Extended works: Ongoing to late 2025
  • Moving underground services
  • Road realignment
  • Commissioning services
  • Road closure between Coleman Parade and Montclair Avenue
  • Traffic management and pedestrian detours
  • Medium levels of noise
  • High levels of vibration
Railway Parade North car park, Glen Waverley

Day/Extended works: Ongoing until mid 2025

Night works: Ongoing intermittently until mid 2025

  • Moving underground services
  • Up to 100 car spaces closed
  • Overnight works for up to 10 nights
  • Traffic management and pedestrian detours
  • Medium levels of noise
  • Light spillage
Railway Parade North, Glen Waverley

Day/Extended works: Ongoing until mid 2025

Night works: Ongoing intermittently until mid 2025

  • Moving underground services
  • Site investigations
  • Road closure between Euneva Avenue and Kingsway
  • Up to 40 car spaces closed
  • Up to 10 car spaces closed within the Euneva West car park
  • Access to Glen Waverley Bus Station will be maintained
  • Traffic management and pedestrian detours
  • Medium levels of noise
  • Light spillage
O'Sullivan Road car park, Glen Waverley

Day works: From early July for up to 2 weeks

Site investigations

  • Up to 10 car spaces closed
  • Traffic management
  • Medium levels of noise
Coleman Parade, Glen Waverley

Day/Extended works:
Ongoing until late July 2025

  • Moving underground
    services
  • Road closure east of Carramar Avenue to Kingsway
  • Up to 60 commuter car spaces closed
  • Traffic management and pedestrian detours
  • Changes to 737 bus route
  • Medium levels of noise

(visit ptv.vic.gov.au to plan your journey)

Glendale Street, Glen Waverley

Day/Extended works:
Ongoing to August 2025

  • Moving underground services
  • Site investigations
  • Up to 7 car spaces closed within the Glendale Street car park
  • Up to 30 car spaces closed within Montclair Avenue car park for up to 4 weeks
  • Traffic management and pedestrian detours
  • Medium levels of noise
Kingsways, glen Waverley

Night works:
From early July for up to 10 nights

  • Moving underground
  • Overnight northbound road closure between Southdown Avenue and Bogong Avenue
  • Traffic management and pedestrian detours
  • Overnight traffic management on Marriott Parade
  • Medium levels of noise
  • Light spillage
Montclair Avenue, Glen Waverley

Day/Extended works:
On 13 July for up to 1 day

  • Moving underground services
  • Road closure between Florence Street and Glendale Street
  • Traffic management and pedestrian detours
  • Medium to high levels of noise

Note: Timing of works may change due to weather or ground conditions.

Glen Waverley Traders will be open for business during works.

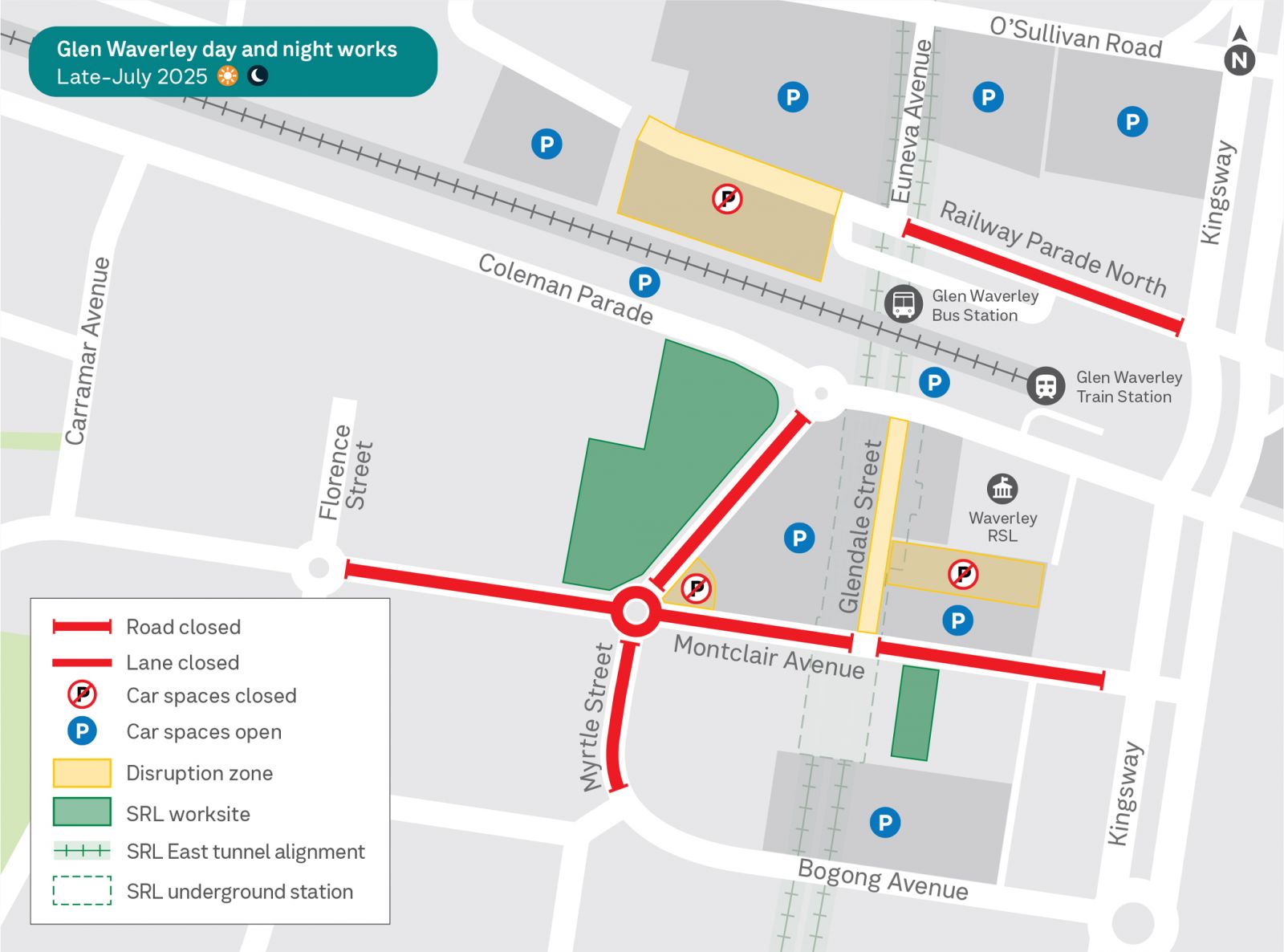

Glen Waverley day and night works. Late July 2025.

WhereWhenWhat we are doingWhat we expect
Myrtle Street, Glen WaverleyDay/Extended works: Ongoing to late 2025
  • Moving underground services
  • Road realignment
  • Commissioning services
  • Road closure between Coleman Parade and Bogong Avenue
  • Traffic management and pedestrian detours
  • Medium levels of noise
  • High levels of vibration
Montclair Avenue, Glen WaverleyDay/Extended works: Late July to late 2025
  • Moving underground services
  • Road closure between Florence Street and Glendale Street
  • Road closure between Glendale Street and Kingsway
  • Traffic management and pedestrian detours
  • Medium levels of noise
Railway Parade North car park, Glen WaverleyDay/Extended works: Ongoing until mid 2025

Night works: Ongoing intermittently until mid 2025
  • Moving underground services
  • Up to 100 car spaces closed
  • Traffic management and pedestrian detours
  • Medium levels of noise
  • Light spillage
Railway Parade North, Glen WaverleyDay/Extended works: Ongoing until mid 2025

Night works: Ongoing intermittently until mid 2025
  • Moving underground services
  • Road closure between Euneva Avenue and Kingsway
  • Up to 40 car spaces closed
  • Access to Glen Waverley Bus Station will be maintained
  • Traffic management and pedestrian detours
  • Medium levels of noise
  • Light spillage
Glendale Street, Glen WaverleyDay/Extended works: Ongoing to late July 2025

Night works: From late July for up to 6 nights
  • Moving underground services
  • Site investigations
  • Up to 7 car spaces closed within the Glendale Street car park
  • Up to 30 car spaces closed within Montclair Avenue car Park for up to 4 weeks
  • Traffic management and pedestrian detours
  • Medium levels of noise

Note: Timing of works may change due to weather or ground conditions.

Impacts

As with all major infrastructure projects, surrounding communities may experience some impacts during construction. The Project supports businesses and residents to continue to live, work, study and shop in their community.

Please contact us on 1800 105 105 to discuss support available if you are impacted by our works.

How we will manage our works

We will minimise impacts to the community by:

  • Maintaining access to the the Waverley RSL, Glendale Street and Montclair Avenue car parks
  • Transporting materials from site in covered trucks to minimise dust
  • Installing road safety and detour signage
  • Maintaining access to homes and businesses
  • Monitoring noise, dust and vibration levels
  • Turning off equipment when not in use
  • Using noise blankets on equipment
  • Using water and dust suppressants
  • Minimising light spill
  • Coordinating disruptions with other construction companies in the area.

Thank you for your patience and cooperation as we progress the delivery of SRL East at Glen Waverley.
