25 March 2025 to 1 May 2025

Works are underway in Heatherton and Clarinda to deliver Suburban Rail Loop (SRL) East  for Melbourne and Victoria.

What we are doing

Stabling Facility in Heatherton

  • Building the Eastern Tunnel Entrance (ETE) and Western Tunnel Entrance (WTE)
  • Building a permanent Network Support Facility (NSF)
  • Moving underground and above ground services.

Tunnel Boring Machine (TBM) launch site, Clarinda

  • Building the Clarinda Tunnel Access Structures (TAS) and a temporary power supply facility for the TBMs
  • Site investigations.

Day works: 7am to 6pm Monday to Friday and 7am to 1pm Saturday
Night works: 6pm to 7am Monday to Saturday
Extended works: 6pm to 10pm Monday to Friday, 1pm to 5pm Saturday and Sunday.
24-hour works at times.

WhereWhen What we are doing What to expect
Stabling Facility, Heatherton

Day/night and extended works: Ongoing to late 2025

  • Building the ETE, with 24 hour excavation and related works
  • Building the NSF
  • WTE Site establishment, including earthworks, concreting, piling and hoarding installation
  • Site investigations
  • Safely removing hazardous material
  • Workers in specialised protective clothing as we continue safe removal of hazardous materials
  • Changed traffic conditions on Henry Street with traffic management in place
  • Temporary fence within the Kingston Linear Reserve. Access maintained
  • Moderate levels of noise, vibration, light and dust
  • Increased truck movements
Kingston Road, Heatherton Day/night/extended works: Ongoing to mid 2025
  • Moving and connecting underground and above ground services
  • Traffic barrier installation and removal
  • Road modifications and asphalting
  • Westbound closure between Old Dandenong Road and Dingley Bypass until early April with crews working 24 hours
  • No right turn from Kingston Road onto Old Dandenong Road until early April
  • Road closure between Dingley Bypass and Peace Road for 1 day in mid April
  • Changed traffic conditions between Golf View Road and Clayton Road with traffic management and detours in place
  • Moderate levels of noise, vibration, light and dust
  • Changes to 631 bus route including closure of some bus stops between Nicholas Grove and Clayton Road

Visit ptv.vic.gov.au to plan your journey

Old Dandenong Road, HeathertonDay/night/extended works: Ongoing to late April
  • Moving underground services
  • Road rectification and asphalting
  • Southbound closure between Kingston Road and Madden Road until early April, with crews working 24 hours
  • Northbound closure between Kingston Road and Madden Road from early April to late April
  • No right or left turn from Old Dandenong Road onto Kingston Road from early April to late April
  • Changed traffic conditions, with traffic management and detours in place
  • Moderate levels of noise, vibration, light and dust
TBM launch site, Clarinda

Day works: Ongoing

Day works: Ongoing
night/extended works:
Ongoing to early May
  • Clarinda TBM launch site establishment, including earthwork, drainage works, piling, and hoarding installation
  • Safely removing hazardous material
  • Workers in specialised protective clothing as we continue safe removal of hazardous materials
  • Changed traffic conditions on Peace Road and Victory Road with traffic management in place
  • Moderate levels of noise, vibration, light and dust
  • Increased truck movements

Note: Timing of works may change due to weather or ground conditions.

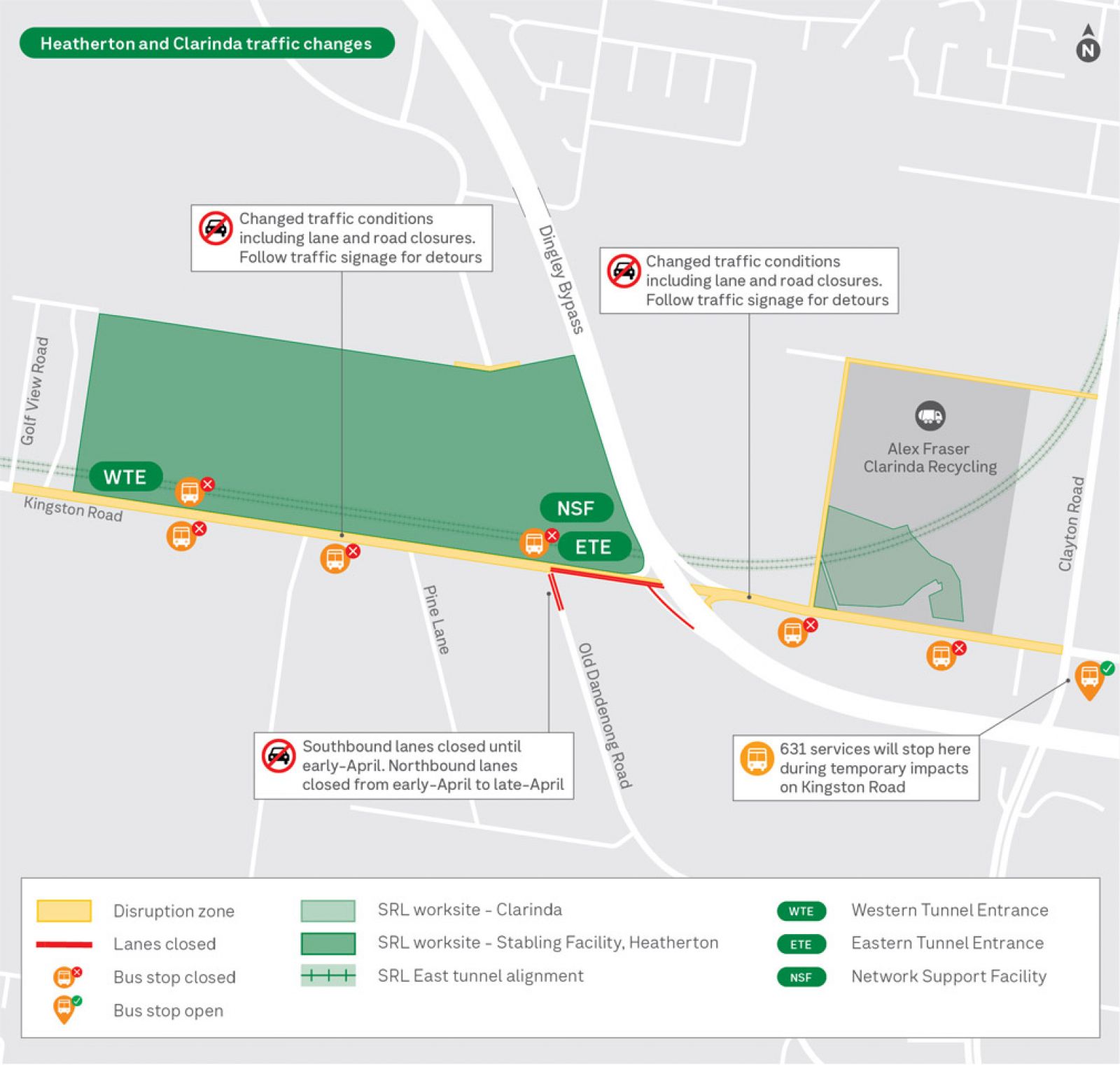

Local traders remain open for business during works.

  • Kingston Road between Golf View Road and Clayton Road
  • Henry Street between at the intersection of Old Dandenong Road
  • Old Dandenong Road between Kingston Road and Madden Road
  • Lanes closed on:

    • Kingston Road westbound between Old Dandenong Road and Dingley Bypass
    • Old Dandenong Road between Kingston Road and Madden Road

    Labels describe:

    • Changed traffic conditions, including lane and road closures on Kingston Road. Follow traffic signage for detours
    • Southbound lanes closed until early-April on Old Dandenong Road. Northbound lanes closed from early-April to late-April.
    • 631 services will stop at route 705 bus stop on Clayton Road near Kingston Road whilst bus stops are temporarily closed.
    ">

    Impacts

    As with all major infrastructure projects, surrounding communities may experience some impacts during construction. The Project supports businesses and residents to continue to live, work, study and shop in their community.

    Please contact us on 1800 105 105 to discuss support available if you are impacted by our works.

    How we will manage our works

    We will minimise impacts to the community by:

    • Covering trucks to minimise dust
    • Monitoring noise, dust and vibration levels
    • Using noise blankets and hoarding to minimise noise, dust and light spill
    • Safely removing hazardous materials in accordance with regulations
    • Using water and dust suppressants
    • Maintaining access to homes and businesses.

    Thank you for your patience and cooperation as we progress the delivery of SRL East at Heatherton and Clarinda.
