Works are underway in Heatherton and Clarinda to deliver Suburban Rail Loop (SRL) East for Melbourne and Victoria.
What we are doing
Train stabling facility, Heatherton
Building the eastern tunnel entrance (ETE) and western tunnel entrance (WTE)
Building the train stabling facility (TSF)
Building a permanent network support facility (NSF)
Tunnel Boring Machine (TBM) launch site, Clarinda
Building the Clarinda tunnel access structures (TAS)
Connecting underground services.
Day works: 7am to 6pm Monday to Friday and 7am to 1pm Saturday Night works: 6pm to 7am Monday to Sunday 24 hour works: 7am to 7am Monday to Sunday
The following works will be carried out during August 2026.

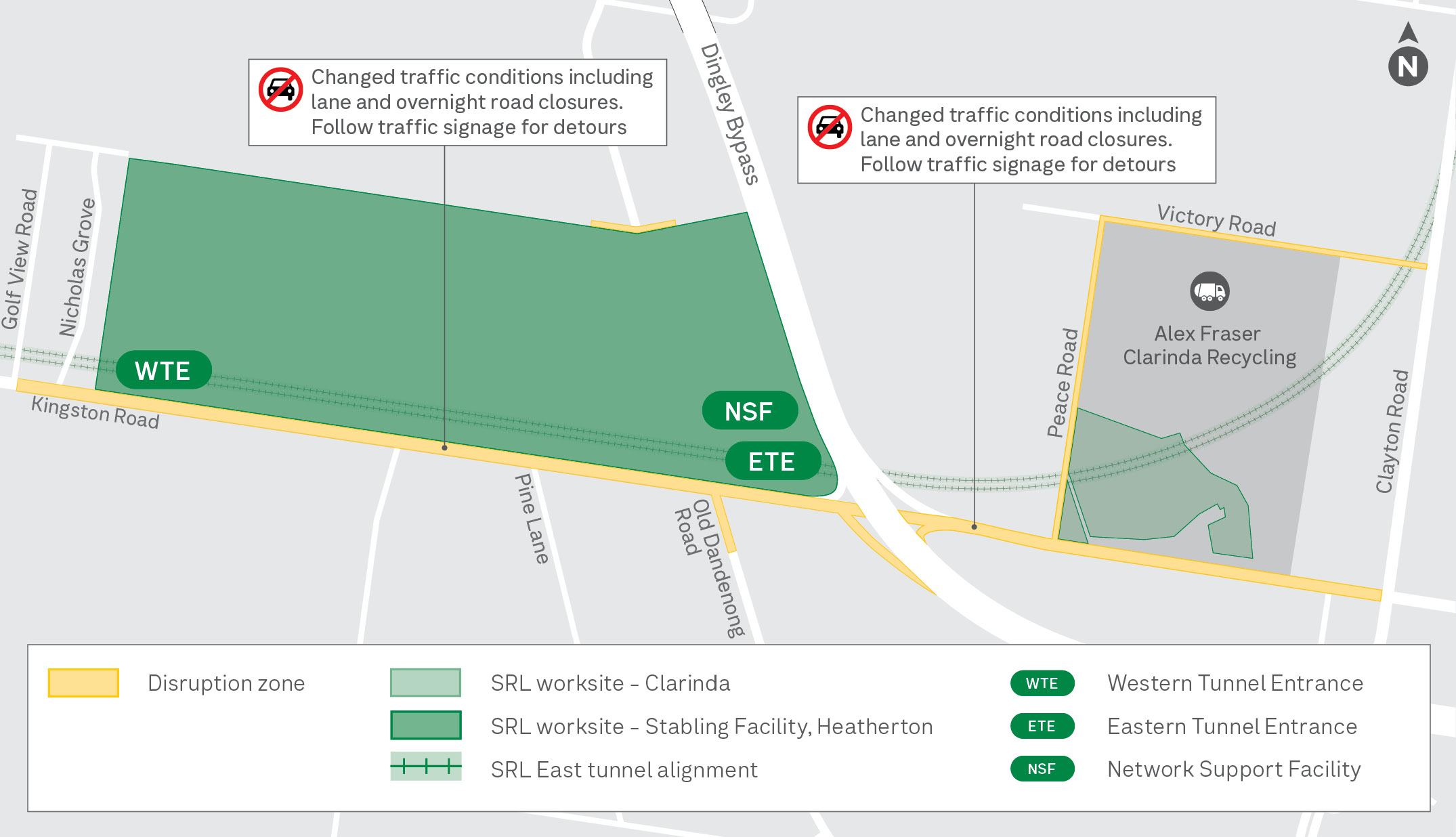

Where
When
What we are doing
What to expect
Train stabling facility west, Heatherton
24 hour works: Ongoing to late 2026
Building the WTE including civil works, earthworks, concreting, steelwork, excavation, piling, water treatment plant operation, and temporary supports construction
Building the train stabling facility including earthworks, excavation, and ground improvement works
Preparing for tunnelling including TBM site set up, foundations for acoustic shed construction, and plant installation works
Site investigations
Safe management and removal of hazardous material
Moving and connecting underground and above ground services
Tree and vegetation removal
Installing monitoring wells in Kingston Walk Linear Reserve
Truck movements and oversized deliveries up to 24/7, including loading and unloading
Workers in specialised protective clothing as we safely remove and manage hazardous materials
Workers in Kingston Walk Linear Reserve at times
Workers and exclusion zones in Henry Street Linear Reserve at times to safely undertake works
Noise, vibration, light and dust
Piling and rolling activities may cause higher levels of noise and vibrations. These works will not be done at night
Train stabling facility east, Heatherton
24 hour works: Ongoing to late 2026
Building the ETE including earthworks, slurry treatment plant and water treatment plant operation
Building the train stabling facility including earthworks, excavation, and ground improvement works
Site investigations
Safe management and removal of hazardous material
Moving and connecting underground and above ground services
Tree and vegetation removal
Truck movements and oversized deliveries up to 24/7, including loading and unloading
Workers in specialised protective clothing as we safely remove and manage hazardous materials
Workers and exclusion zones in Henry Street Linear Reserve at times to safely undertake works
Noise, vibration, light and dust
Piling and rolling activities may cause higher levels of noise and vibrations. These works will not be done at night
TBM launch site, Clarinda
24 hour works: Ongoing to late 2026
Building the Clarinda TBM launch site including civil works, concreting, shaft excavation and strut installation and base slabs
Preparing for tunnelling including TBM site set up, acoustic shed & Spoil shed construction and plant installation works
Moving and connecting underground and above ground services
Ground improvement works
Changed traffic conditions on Victory Road
Truck movements and oversized deliveries up to 24/7, including loading and unloading
Peace Road entry at Kingston Road closed until late 2026. Entry to Peace Road via Victory Road
Noise, vibration, light and dust
Kingston Road, Heatherton
Day/night works: Ongoing through 2026
Road modification and reinstatement
Moving and connecting underground and above ground services
Traffic barrier movements
Intermittent overnight road closures from Nicholas Grove to Clayton Road
Changed traffic conditions between Warrigal Road and Clayton Road with traffic management in place
Changes to 631 bus route including closure of some bus stops between Nicholas Grove and Clayton Road
Note: Timing of works may change due to weather or ground conditions.
Local traders remain open for business during works.
Additional short-term traffic changes will be in place around the Heatherton and Clarinda area as we complete site investigation works.
There will be increasing major works activities, including earthworks and piling, across the train stabling facility site.
